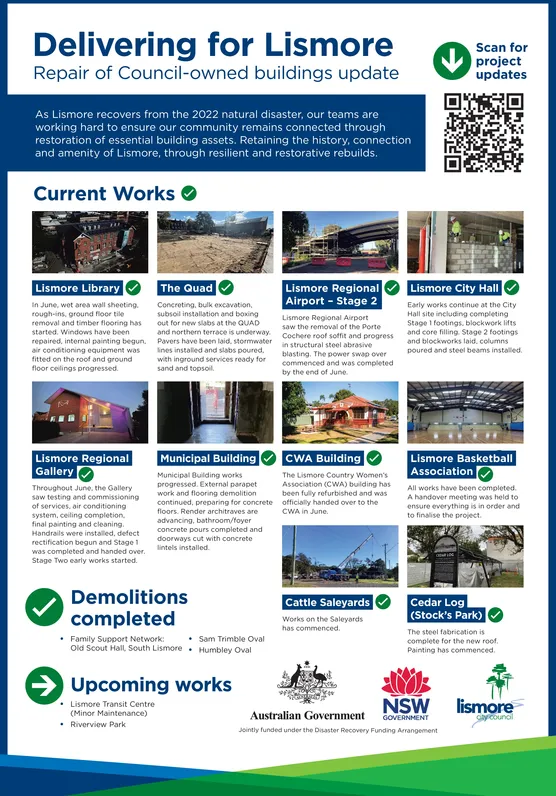

Delivering for Lismore Repair of Council-owned buildings update Scan for project updates As Lismore recovers from the 2022 natural disaster, our teams are working hard to ensure our community remains connected through restoration of essential building assets. Retaining the history, connection and amenity of Lismore, through resilient and restorative rebuilds. Current Works Lismore Library In June, wet area wall sheeting. rough-ins, ground floor tile removal and timber flooring has started. Windows have been repaired, internal painting begun. air conditioning equipment was fitted on the roof and ground floor ceilings progressed. The Quad Concreting, bulk excavation, subsoil installation and boxing out for new slabs at the QUAD and northern terrace is underway. Pavers have been laid, stormwater lines installed and slabs poured. with inground services ready for sand and topsoil. Lismore Regional Airport - Stage 2 Lismore Regional Airport saw the removal of the Porte Cochere roof soffit and progress in structural steel abrasive blasting. The power swap over commenced and was completed by the end of June. Lismore City Hall Early works continue at the City Hall site including completing Stage 1 footings, blockwork lifts and core filling. Stage 2 footings and blockworks laid. columns poured and steel beams installed. Lismore Regional Gallery Throughout June, the Gallery saw testing and commissioning of services, air conditioning system, ceiling completion. final painting and cleaning. Handrails were installed, defect rectification begun and Stage 1 was completed and handed over. Stage Two early works started. Municipal Building Municipal Building works progressed. External parapet work and flooring demolition continued, preparing for concrete floors. Render architraves are advancing, bathroom/foyer concrete pours completed and doorways cut with concrete lintels installed. CWA Building The Lismore Country Women's Association (CWA) building has been fully refurbished and was officially handed over to the CWA in June. Lismore Basketball Association All works have been completed. A handover meeting was held to ensure everything is in order and to finalise the project. Demolitions completed Family Support Network: Old Scout Hall, South Lismore Sam Trimble Oval Humbley Oval O Upcoming works Lismore Transit Centre (Minor Maintenance) Riverview Park Cattle Saleyards Works on the Saleyards has commenced. Cedar Log (Stock's Park) The steel fabrication is complete for the new roof. Painting has commenced. Australian Government NSW GOVERNMENT Jointly funded under the Disaster Recovery Funding Arrangement lismore gay council Delivering for Lismore Repair of Council - owned buildings update Scan for project updates As Lismore recovers from the 2022 natural disaster , our teams are working hard to ensure our community remains connected through restoration of essential building assets . Retaining the history , connection and amenity of Lismore , through resilient and restorative rebuilds . Current Works Lismore Library In June , wet area wall sheeting . rough - ins , ground floor tile removal and timber flooring has started . Windows have been repaired , internal painting begun . air conditioning equipment was fitted on the roof and ground floor ceilings progressed . The Quad Concreting , bulk excavation , subsoil installation and boxing out for new slabs at the QUAD and northern terrace is underway . Pavers have been laid , stormwater lines installed and slabs poured . with inground services ready for sand and topsoil . Lismore Regional Airport - Stage 2 Lismore Regional Airport saw the removal of the Porte Cochere roof soffit and progress in structural steel abrasive blasting . The power swap over commenced and was completed by the end of June . Lismore City Hall Early works continue at the City Hall site including completing Stage 1 footings , blockwork lifts and core filling . Stage 2 footings and blockworks laid . columns poured and steel beams installed . Lismore Regional Gallery Throughout June , the Gallery saw testing and commissioning of services , air conditioning system , ceiling completion . final painting and cleaning . Handrails were installed , defect rectification begun and Stage 1 was completed and handed over . Stage Two early works started . Municipal Building Municipal Building works progressed . External parapet work and flooring demolition continued , preparing for concrete floors . Render architraves are advancing , bathroom / foyer concrete pours completed and doorways cut with concrete lintels installed . CWA Building The Lismore Country Women's Association ( CWA ) building has been fully refurbished and was officially handed over to the CWA in June . Lismore Basketball Association All works have been completed . A handover meeting was held to ensure everything is in order and to finalise the project . Demolitions completed Family Support Network : Old Scout Hall , South Lismore Sam Trimble Oval Humbley Oval O Upcoming works Lismore Transit Centre ( Minor Maintenance ) Riverview Park Cattle Saleyards Works on the Saleyards has commenced . Cedar Log ( Stock's Park ) The steel fabrication is complete for the new roof . Painting has commenced . Australian Government NSW GOVERNMENT Jointly funded under the Disaster Recovery Funding Arrangement lismore gay council
